By Meco Engineering Team·Published: ·Updated: IATF 16949:2016
Contract manufacturing turns a product specification into parts or finished goods through an outside production partner. The work usually moves from scoping and design review to sourcing, pilot builds, production, inspection and delivery.
Outsourcing a product build is more than finding a factory with the right machines. This guide explains the work that happens between the first request for quotation and a released shipment, and the questions to settle at each handoff.
- Define product requirements and ownership before requesting a firm quote.
- Use a design review and samples to test process and assembly assumptions.
- Agree on inspection records, changes and supplier responsibilities.
- For multi-process products, manage interfaces between parts and teams.
What is contract manufacturing?
Contract manufacturing is an arrangement in which a business hires another company to make its parts, assemblies or products to an agreed specification.
The customer defines the product, acceptance criteria and commercial requirements. The manufacturer supplies the production processes, staff and agreed materials or services. The scope can cover one component or the whole build.
For a complete product, the handoffs between metal parts, plastic parts, electronics, finishing and assembly matter as much as any one process. Meco describes this broader scope in its whole product manufacturing service.
What happens during contract manufacturing?
A typical program moves through scope, engineering review, samples, sourcing, production, inspection and delivery. The exact sequence depends on the product and the responsibilities in the agreement.
A supplier should explain who approves each stage and what evidence will be provided. That is especially useful when one product combines several processes.
- Scope and RFQ. Share drawings, target volume, expected use, materials and inspection needs. The team identifies missing information before pricing.
- Design review. Manufacturing engineers review geometry, tolerances, assembly interfaces and the processes that could meet the requirements.
- Commercial agreement. The parties define responsibilities for tooling, supplied materials, changes, quality records, delivery and intellectual property.
- Prototype and pilot. Sample parts test fit, function and process choices. A pilot build can reveal problems that a single prototype does not.
- Sourcing and planning. The team orders materials and components, confirms suppliers and plans inspection points and production capacity.

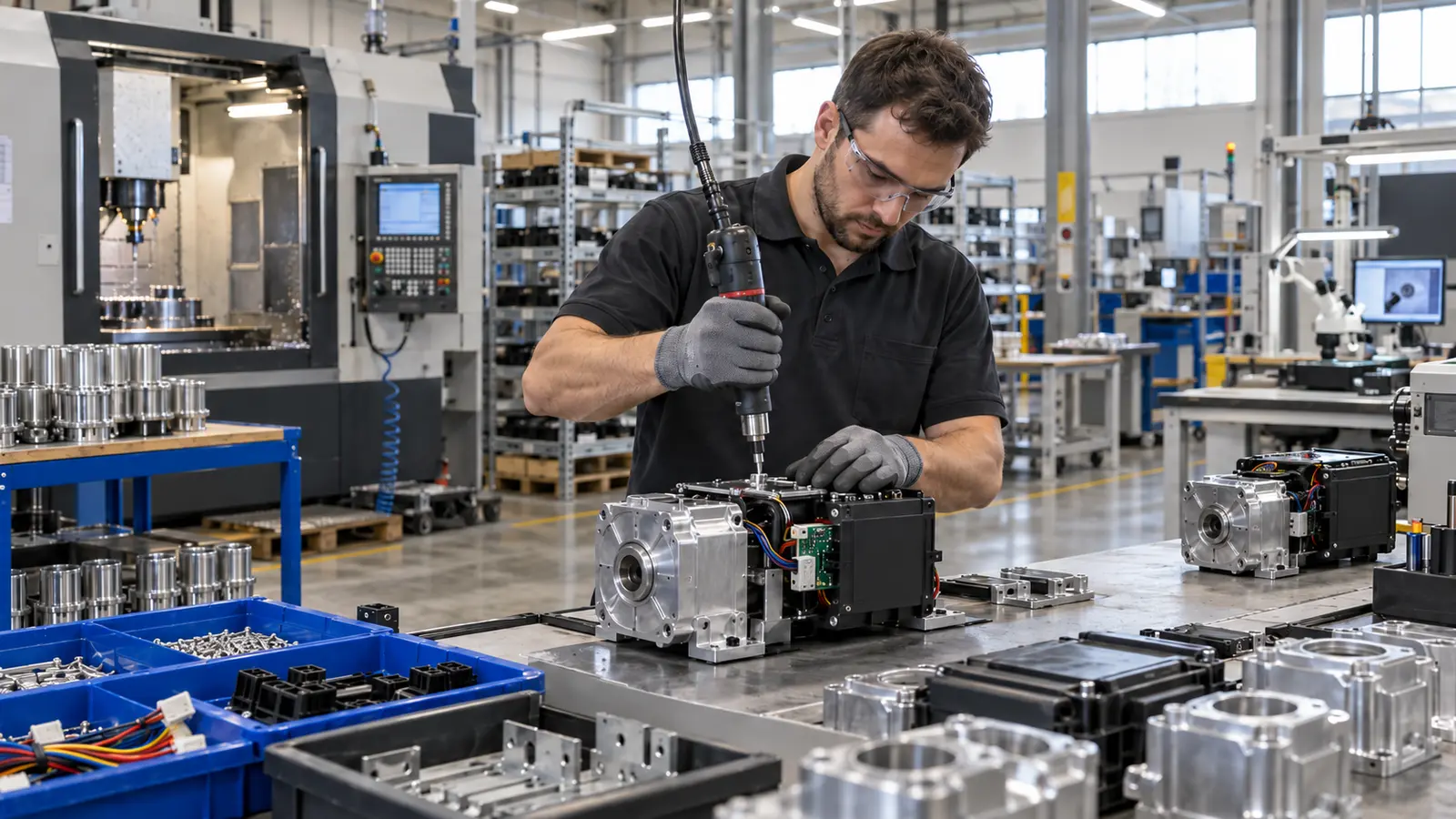

- Production and assembly. Approved processes make the parts. Assembly brings them together under controlled instructions and revision levels.
- Inspection and release. Inspection compares the output with the agreed drawing and acceptance criteria. Deviations require review before release.
- Packaging and delivery. Parts are packed to protect finished surfaces and labeled to support the agreed traceability and shipment plan.
The same sequence also appears in the prototype to production guide, which looks more closely at the handoff from early builds to repeatable output.
What information does a manufacturer need to quote?
A useful request for quotation describes the product, quantity, quality requirements and target schedule in enough detail to compare proposed methods.
Start with the latest drawing or 3D model and identify the revision. State the material and finish, annual demand, expected order sizes and any forecast changes. Mark the features that affect fit or function, such as sealing faces, hole locations or electrical connectors.
Describe the intended environment. A housing used outdoors may need different finish and sealing choices from one used indoors. If a finished unit needs assembly, explain which parts the customer will supply and which parts the manufacturer should source.
Ask each bidder to separate recurring unit costs from tooling, fixtures and one-time engineering work. Request a list of assumptions and exclusions. If a quote assumes the customer supplies a circuit board or performs final testing, that work still needs an owner and a budget.
Early concepts do not always have a final drawing. A sketch, reference part or rough bill of materials can start the conversation, but any preliminary estimate should state its assumptions. Before release, replace open assumptions with an agreed specification and acceptance plan.
Where do multi-process handoffs create risk?
Interfaces between processes often cause rework when teams agree on each part but leave the finished assembly unclear.
Consider a die cast aluminum housing with a machined sealing face, an injection molded cover and a populated circuit board. A change to the housing datum can affect machining, cover fit, connector position and final inspection. That example illustrates a design tradeoff; it does not describe a specific customer project.

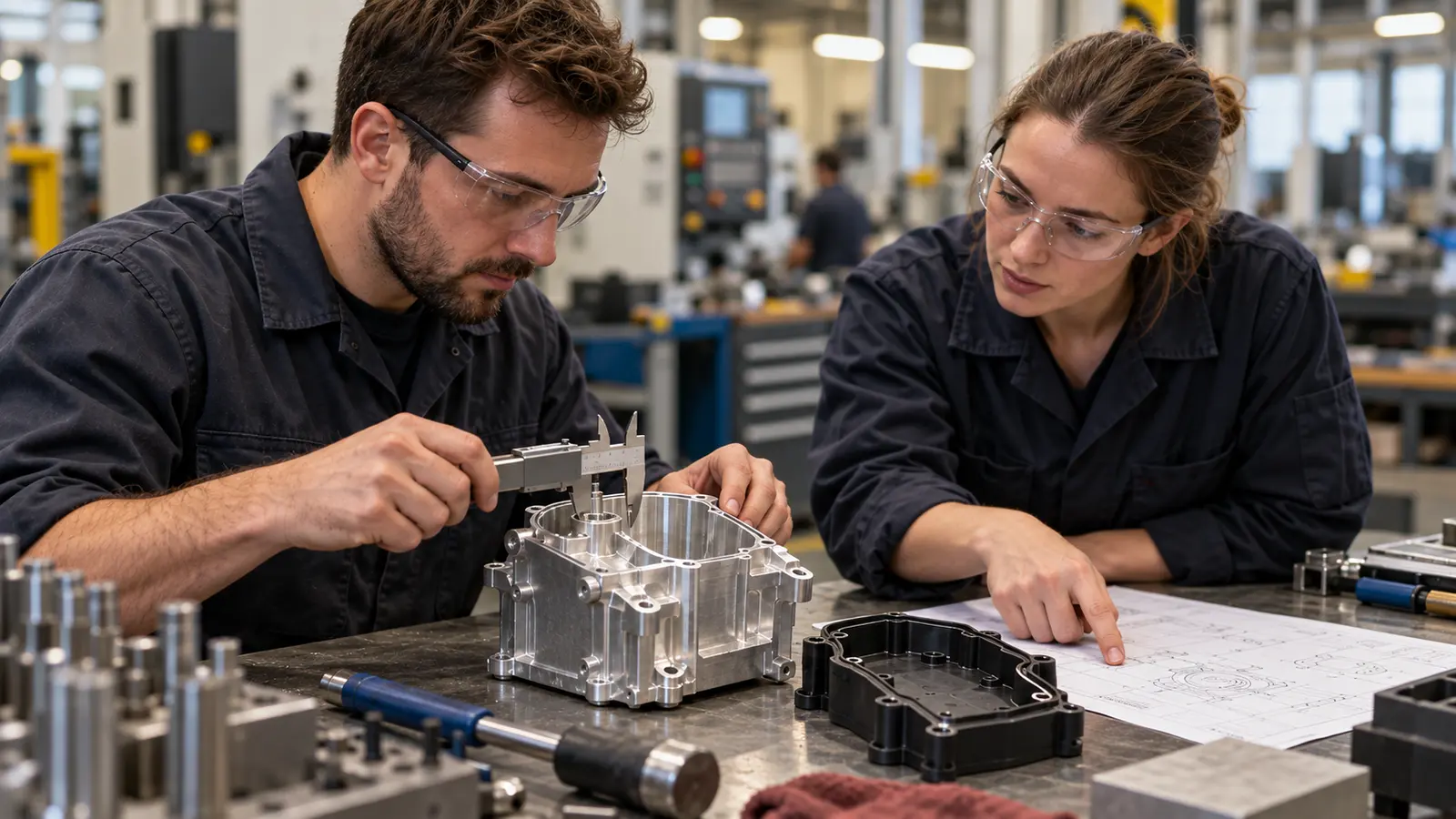

At the design review, identify the critical dimensions, who owns the common drawing revision and how assembly fit will be checked. Meco can coordinate die casting, CNC machining and mechanical assembly as part of a wider build. Define each interface before tooling is released.
What types of contract manufacturing are common?
The term covers component production, assembly and full product builds. The supplier scope matters more than the label.
Component manufacturing
A manufacturer makes specified parts such as castings, machined components or molded housings. The customer or another supplier may complete the final assembly.
Contract assembly
A partner receives or sources components, builds an assembly and tests it to agreed instructions. See the contract assembly guide for the difference between assembling parts and owning the full supply chain.
Turnkey manufacturing
A partner takes responsibility for more of the sourcing, production, finishing, assembly and delivery plan. Ask which processes are performed directly and which rely on outside suppliers. The answer affects control, lead time and issue resolution.
How do OEM, ODM and private label models differ?
These labels describe different roles in design and production, so clarify who defines the product before selecting a supplier.
An original equipment manufacturer (OEM) commonly owns a product design and may contract another company to build it. The contract manufacturer works to agreed requirements and may provide engineering feedback, but its design role depends on the agreement.
An original design manufacturer (ODM) develops a product design that a customer may sell under its own brand, subject to the commercial terms. In private label manufacturing, a seller typically chooses from an existing product and applies its brand or specified variations.
These models can overlap. A customer may bring the core design while asking the supplier to redesign a bracket or select a standard component. Record which party approves each change, owns the resulting design and maintains the production files. The label alone cannot settle those questions.
Why do companies use contract manufacturers?
Companies use contract manufacturers to access production capacity and specialist processes without building every capability themselves.
That can reduce upfront investment and give a team room to scale after demand is proven. The outcome depends on the product, the supplier and the terms of the program, so do not assume a lower unit cost or a faster launch in every case.
A suitable partner can also bring design for manufacturability feedback, production planning and a documented quality process. The greatest value for a complex assembly may come from fewer supplier handoffs and clearer ownership of changes.
Planning a multi-process build? Send your design and target volume so our team can review the manufacturing steps and quote requirements.
Talk to an EngineerWhat happens between a prototype and full production?
A prototype checks a design idea; a pilot build checks whether the planned production method can make it repeatedly.
A prototype may be machined even when the production plan calls for a casting. It can show whether a part fits, but it cannot by itself prove that a casting tool will fill correctly or that later machining has enough stock. State what each sample is meant to validate.
Before a pilot build, freeze a working drawing revision, confirm the proposed material and approve the inspection method. A pilot should test real assembly steps and reveal any difficult handoffs between sourcing, fabrication and finishing.
Record defects and the changes made to address them. Repeat affected tests when a change alters a critical feature. The release decision should identify approved samples, open issues, expected volume and the records required for the first production order.
How are quality requirements managed?

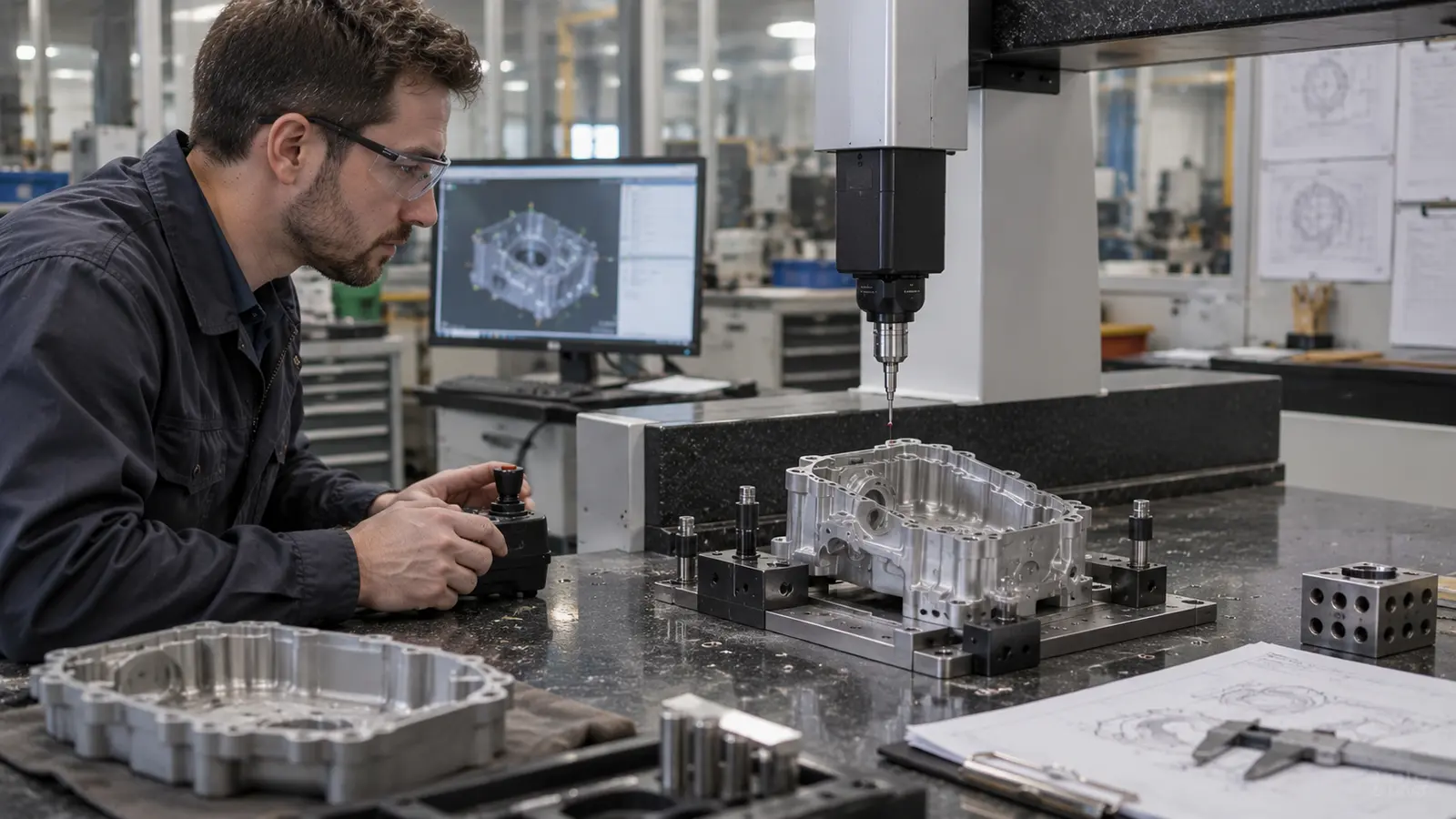

Quality starts with an agreed drawing and acceptance plan, then continues through incoming checks, process controls and final inspection.
Agree which characteristics need measurement, the sample size, how results are recorded and who approves a deviation. If your program requires first article inspection (FAI), Production Part Approval Process (PPAP) records or coordinate measuring machine (CMM) reports, request those deliverables in the quote.
Meco states that it holds IATF 16949:2016 certification. Check the certificate scope against the location and processes relevant to your program. A supplier certification by itself does not approve a part or replace customer-specific acceptance criteria.
How are production changes controlled?
A controlled change process keeps the drawing, tooling, purchased parts and inspection plan on the same revision.
Suppose a customer changes a connector location after the cover tool has been approved. The change may affect the circuit board, molding tool, housing machining and final fit test. A verbal request to one supplier will not update the whole build.
A practical change request identifies the affected part numbers and revisions, the reason for the change and the proposed effective date. The manufacturer then reviews cost, available stock, tooling work, inspection changes and delivery impact. Both parties approve the plan before the new revision enters production.
Decide how to handle work already in progress. Some parts can be reworked; others may need to be used under a documented deviation or replaced. Keep the approval record with the build documentation so future orders do not return to an older version.
For multi-process products, appoint one owner to coordinate updates across suppliers. This is a useful question to ask a potential turnkey partner: who makes sure a change reaches every team that touches the product?
What affects contract manufacturing cost?
The quote reflects materials, process time, tooling, volume, inspection, finishing, assembly and logistics.
Compare quotes using the same drawing revision and expected annual volume. Ask whether tooling, test fixtures, packaging and engineering changes are included. A low piece price may be offset by tooling or by separate charges for quality documentation.
The design can also change the economics. If a tighter tolerance applies only to one mating face, call it out there instead of imposing it on every surface. See Meco’s metal part cost guide for a process-specific cost breakdown.
What should a manufacturing agreement cover?
The agreement should make product scope, approvals, changes and delivery responsibilities clear to both parties.
Begin with the controlled documents: drawings, specifications, approved samples, bills of materials and any test instructions. State how new revisions enter the build. Without a clear document hierarchy, a purchase order can refer to one revision while the shop floor uses another.
Record who buys each material, who owns tooling and who pays for repair or modification. Define when the customer may review or retrieve its tooling. The parties should also agree how forecasts turn into firm orders, and which costs apply if an order changes after materials have been purchased.
Quality terms should identify inspection records, deviation approvals and the response when a shipment fails acceptance. Set responsibilities for packaging, freight, delivery and any customer-supplied parts. Ask a qualified adviser to review legal and intellectual property terms for the specific program; an article cannot settle them for every project.
What happens after parts leave production?
Packaging and shipment are part of the manufacturing plan because damage or missing records can prevent a customer from using good parts.
Specify how machined faces, coatings, connectors and assembled units need to be protected. A heavy casting and a finished electronics enclosure may need different handling. Labels should let the receiving team identify the part number, revision and quantity without opening every package.
Decide which inspection reports, material records or assembly test results must travel with a shipment. If partial deliveries are allowed, agree which components must arrive together so that a missing part does not stop the customer's final build.
After the first order, review scrap, fit issues, delivery changes and customer feedback. A repeat order should use the approved revision and any corrective actions from the earlier build. This feedback loop is how a contract manufacturing program becomes more predictable over time.
What risks should buyers plan for?
Most preventable problems come from unclear scope, weak revision control, untested capacity or incomplete inspection requirements.
Material availability can delay a build even when machines are ready. Ask whether the quote depends on one supplier, a long-lead component or customer-supplied stock. Agree in advance which substitutions need written approval.
Capacity planning matters when demand changes. A supplier that can make ten samples may need new fixtures, staff or supplier commitments to deliver thousands of finished units. Review the ramp plan, the bottleneck process and the point at which new capacity must be reserved.
Quality risk can hide between separately approved parts. Set a final assembly test or fit check where the product requires one. Agree how nonconforming parts will be contained, reviewed and replaced, and what evidence the supplier will send with each shipment.
Finally, protect the design files and tooling through clear access and ownership terms. Buyers with regulated products should define the documentation and approvals needed for their own market. A general manufacturing quality certificate does not replace product-specific obligations.
How should you choose a manufacturing partner?
Choose a supplier whose process capability, quality plan and communication match the actual build.
Share the same request for quotation with each candidate, then ask how they would make and inspect the product. Look for clear answers about process boundaries, sample approval, supplier management and change control.
- Capability: Can the supplier make or coordinate each required process?
- Quality: Can the team show the inspection plan and required records?
- Ownership: Who resolves problems between components and suppliers?
- Capacity: How will the program move from samples to the target volume?
- Communication: Who approves changes, and how are revisions recorded?
For a focused checklist, use the guide to finding a manufacturer before issuing your RFQ.
